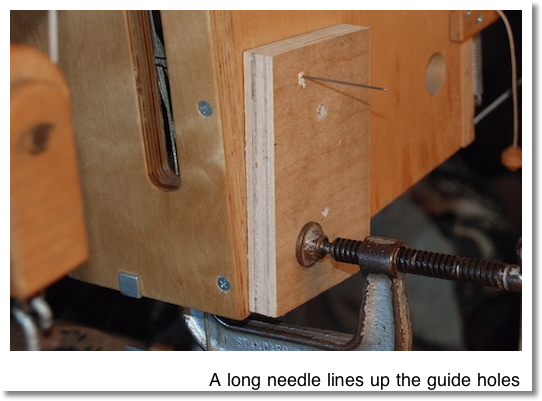

And here are the tricks to drilling a clean hole: clamped blocks and guide holes. First, I marked the location and drilled a tiny hole in the dobby box.



Then I drilled matching holes in two blocks of wood and used a shibori needle to line up the three holes while I securely clamped the blocks into place. These blocks keep the edge of the hole from splintering when the drill bit enters or exits the wood.





And here's the result: a new peg on a chain and a hole to insert it.



Here's one new view of some thread problems in the shed. It'll really help me to be able to fix them in the best way possible if I can stand up from my bench and get at these things from multiple angles.

Sunday, February 27, 2011

Celestial Geometry and Birdhouses

We've decided to encourage the tree swallows to settle in our valley again, this time in nest boxes high up on slippery poles. That should prevent the snakes from getting the young.

We also decided to increase the number of boxes in the hopes of increasing the number of cheer-bringing birds. 12 seems like a good number, and makes for an interesting construction challenge.

As long as we're making a new feature on the land, I'm taking it upon myself to practice celestial navigation and surveying geometry. I'm planning the 12 new posts to lie evenly on a circle that's oriented to true North. We're doing the orientation and construction using only two pieces of string and our eyes.



We had chosen our center location and a radius that would have the nests far enough away from each other and the places where people travel. Then, we were just waiting for a clear night to find North.

Last night, I woke up at 4:00 AM to find the sky crystal clear. It was a perfect time to go out and sight the center line. I drove a stake lined up with the center stake and Polaris to capture the North line.





This morning, Wispr and I went out with some wool yarn to place the rest of the stakes. The first thing that we noticed was that the radius stake, which we had placed "roughly" in the north, was absolutely dead on. I guess we have a better understanding of North than we had thought.

With the 12:00 stake placed, we used line-of-sight and one of the radius strings to place the 6:00 stake.

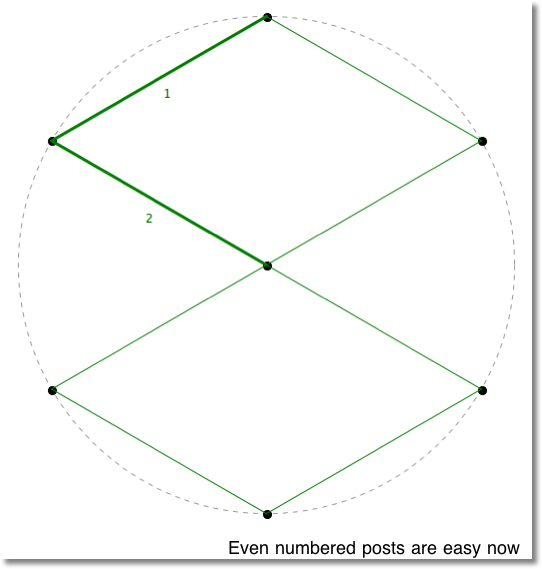

With the center, 12:00, and 6:00 stakes in place, we can use two copies of our radius string to place the rest of the even-numbered stakes. We now have a hexagon oriented to North.



The next step is a specific to the medium - fold one of the radius strings in half and tie a knot. Now, when that string is stretched between any pair of even-numbered stakes, a radius from the center that passes over that knot will give us the location of the odd-numbered stake between them.



And, that's it! Now we can dig the post holes and sink our poles to create a near-perfect 12-pointed circle aligned to North.

More Samples

The long-repeat meandering zigzag is definitely a success. It creates visual tension against the straight lines of the individual threads, and helps the cloth to look more organic and complex.





I promise that I'll soon be posting pics of the washed cloth. The pattern really pops out when the cloth shrinks.

Saturday, February 26, 2011

Arctic Fox Samples

It's photo essay blog catch-up day. I'm working my butt off for a March launch of my new line of wedding shawls and cloaks, inspired by the coloration of the Arctic Fox. In the next few days I'll post closeups of the color samples after they've been washed and dried.











Tie-on

Here's another quick photo essay on pulling threads through the heddles. It's tough to convey how finicky this work is, particularly because I don't stop halfway through it to take pictures.




[...and then a lot of work happens...]






Warping Frame

Wow, the weeks are flying by like days right now! The weather is grey and cold so it's tough to get up the energy to get my stuff done. I've been doing it, but haven't had the extra energy to write about it.

Today I wet-finished the sample swatches for the new beam, but I've got some other stuff I want to write about before I show them off. First, is the other new piece of equipment that I had to make in order to warp the beam...



The last time I did this, I made due with a reed hung from the ceiling. It was very slow and finicky, partly because I could not get the cones directly below it.

The solution is to set up a device so that each cone feeds to the section of a screen that lies directly above it. This lets cones feed easily without tipping over.

There is one big problem with this setup, though. I wind from the center outward, alternating sides. Since the pattern is roughly symmetrical, I have ended up reversing the cones for each section. This means unthreading them from the screen, reversing the cones, making any changes to the thread order, and rethreading the screen.

Before the next beam, I've got an idea that would cut out a lot of work: I'm designing a rolling cone rack and warping frame. I'll be able to reverse the cones just by turning the rack around, and roll it out of the way at the end of a days' work. It will also have pegs so I can stack a cone with its replacement cone and it won't fall off.

So, this rack worked well enough and showed me how I can make it even better for next time.

Friday, February 25, 2011

Setting A Price On Craftwork: Task Switching

In my last post on the topic, I mentioned the idea of doing one operation to many pieces. I want to talk a little more about that.

In project management, they talk about "startup cost". In accounting, this refers to the costs associated with starting a business. In project management, it refers to the time that it takes a person to start a task or change from one task to another. It is critical to keep this in mind when doing craftwork for a living. Let me start with an example...

Let's say a jeweller needs to make 100 pairs of earrings. Each one has a square of stone hung from a French hook by a rim of gold. The intuitive way to proceed is to cut and polish two stones, cut the gold, solder, burnish, attach the hanging ring and attach the French hooks. Whew! That's one pair done.

Now let's look at the startup costs.
1. Get out stone, put on protective gear and start up the cutter. 2 minutes. Cut two stones.
2. Put on a coarse grit belt. 3 minutes. Rough out stone.
3. Switch to medium grit belt. 2 minutes. Start polish.
4. Switch to fine grit belt. 2 minutes. Finish polish.
5. Get out gold, metal snips, etc. 3 minutes. Cut gold.
6. Get out soldering iron, etc. 2 minutes. Solder gold.
7. Get out shaping and burnishing tools. 2 minutes. Burnish gold.
8. Get out mounting hardware. 2 minutes. Attach hardware.

Overall, it's probably taken an hour to make this pair of earrings, 18 minutes of which was spent switching tasks. This is a low estimate based on quickly switching tasks and staying focused. Many people don't have a separate area for each task so things need to be moved around a lot when switching tasks. Tools can get misplaced in the process, taking even more time.

If you're anything like me, task switching also feels like a great time for a quick break. 5 minutes here, 10 minutes there and poof! The day is gone.

This is the point where many crafters look backwards at the numbers. "I bring in $25 for a pair of earrings and they only cost $5 in materials and take an hour to make, so that's $20 an hour." Once we take income tax, overhead, and the financial and time cost of making the sales, it's probably more like $8-12/hr.

To reduce the startup costs, this jeweller could do each operation to all 100 pairs and the startup costs would drop to 1% of what they were. That 18 minutes of startup cost per pair of earrings becomes 10 seconds per pair. To make the whole batch, she would have saved 30 hours in repetitive tasks and her wage will have jumped to $12-18/hr.

If she could find a niche or improve the customer experience in some other way, she could probably raise her retail price and earn the $20/hr that she wanted.

In my space-limited studio, I've reduced repetition by performing my tasks in a pipeline. First I warp the beam for 80 yards of cloth, then I weave it all and store the cloth on top of the loom or in mouseproof boxes.

Even the weaving is pipelined. I get out enough weft yarn to finish the cloth I'm making in that color and line it all up on a shelf. I wind all the bobbins I have (40) and keep them organized in a box. Then I sit and weave until they're gone or my body needs a break. The cloth collects on the back beam until 1. the current color is finished or 2. there are 30 yards of cloth on the take-up beam.

And, when it's time to sew, I reconfigure the studio for that task and make lots of whatever product it is that I'm making. It's easier to pull out cloth and make many colors of the same product than it is to refer to my design notes and retrain myself to measure, cut and sew a different product.

So, if you find that you have to charge prices higher than your competition in order to pay yourself a fair wage, look for ways to cut out task startup costs. See if you can make many copies of an item in less time than you could if you were making them one at a time.
